📌 Key Takeaways
- Two questions determine which of the four lien waiver types is used: (1) Have you been paid yet? and (2) Is the payment a progress payment or the final payment?
- Conditional lien waivers are used before payment, while unconditional lien waivers are used after payment has been received.
- Progress lien waivers cover interim payments, while final lien waivers cover the last payment on a project, including retainage.
- Collecting the correct lien waivers—both your own and any required lower-tier waivers—helps prevent payment delays and protects your lien rights.
Lien waivers show up on more commercial projects every year, and they're one of the easiest places for a payment to get hung up. Submit the wrong form, leave out a required detail, or sign an unconditional waiver before the money actually arrives, and the GC's accounts payable team sends the whole pay app package back, leaving a month of billing stuck while you sort it out.
The good news is that the rules aren't complicated once you can see them laid out. Below, we break down the main types of lien waivers and when to submit each one, how your own waivers differ from the ones your vendors owe you, and a few practical ways to keep the whole process moving.
How to Choose the Right Lien Waiver
There are four types of lien waivers in construction, but they're all created by answering two simple questions:
- Have you been paid yet?
- Is this a progress payment or the final payment?
Once you know the answers to those two questions, you'll know exactly which lien waiver to use.
Conditional or Unconditional: “Have You Been Paid Yet?”
The terms conditional and unconditional describe whether the lien waiver depends on receipt of payment.
- Conditional means the lien waiver only becomes effective if payment is actually made.
- Unconditional means the waiver is effective immediately because payment has already been received.
Progress or Final: “What Payment Is This For?”
The terms “progress” and “final” describe which stage of the project the payment covers.
- Progress means the waiver is tied to a progress payment for work completed up to a certain point in the project.
- Final means the waiver is tied to the final payment that closes out the contract.
Put Them Together

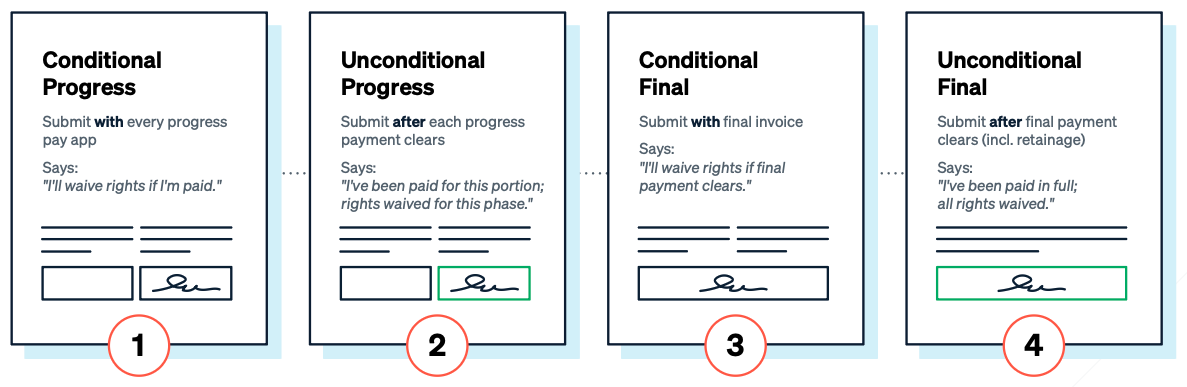

Those two decisions create the four lien waiver types:
Why Each Lien Waiver Exists
By now, you know how to identify the correct lien waiver. The next piece is understanding why each one exists in the payment process.
Lien waivers aren't just paperwork. They allow the payment process to move forward while protecting both you and the GC at different stages of the billing cycle. Each one serves a specific purpose, and using it at the right time helps avoid unnecessary payment delays while ensuring you don't give up lien rights before you've actually been paid.


Conditional Progress
A conditional progress waiver allows the GC to process your progress payment without requiring you to give up lien rights beforehand. Because the waiver only becomes effective once payment is actually made, it protects you if the payment is delayed or never arrives.
That's why this is the waiver you'll typically submit with each monthly pay application. Many GCs require it before they'll release payment, so including it keeps your billing package moving while preserving your lien rights until the money is in your account.
Unconditional Progress
Once you've received a progress payment, the GC typically needs confirmation that you've waived lien rights for that portion of the work. That's the purpose of an unconditional progress waiver.
Because this waiver is effective immediately upon signing, don't sign it until the payment has actually cleared. Signing too early can leave you without lien rights if the payment falls through. On the other hand, waiting too long to submit it can slow down future pay applications, since many GCs require executed unconditional waivers before processing the next billing cycle.
Conditional Final
The conditional final waiver serves the same purpose as a conditional progress waiver, but for the last payment on the project. It allows the owner or GC to process the final payment—including retainage—while ensuring your lien rights remain intact until you've actually been paid in full.
It's commonly included with your final pay application as part of the project's closeout documentation.
Unconditional Final
The unconditional final waiver is the last step in the waiver process. It confirms you've received every dollar you're owed—including retainage—and permanently waives any remaining lien rights on the project.
Because this is your final opportunity to preserve those rights, don't sign it until the funds have actually reached your account. Once payment has cleared, promptly submitting the waiver helps complete project closeout and satisfies one of the final administrative requirements for closing the job.

Your Waivers vs. Your Vendors' Waivers
Up to this point, we've been talking about your lien waivers—the ones you submit to the GC in exchange for payment. But on many commercial projects, those aren't the only waivers involved.
If you hire material suppliers, equipment vendors, or lower-tier subcontractors, the GC may also require lien waivers from them before processing your payment.
Here's the difference:
- Primary lien waivers are the ones you complete and submit to the GC, releasing your lien rights for the work your company performed.
- Lower-tier lien waivers are the ones from your vendors, suppliers, and subcontractors, releasing their lien rights for the work they performed.
Because you hired those lower-tier parties, it's typically your responsibility to collect their waivers and include them with your pay applications whenever the GC requires them. Some GCs require lower-tier waivers for every billing cycle, while others only request them for certain vendors or at specific stages of the project. It should be outlined in the contract.
Fortunately, the timing follows the same framework you've already learned. As your vendors bill and get paid, you'll collect the same four waiver types from them:
The challenge usually isn't understanding which waiver to request, but rather, it's managing the sheer volume. On a project with a dozen suppliers or lower-tier subcontractors, every billing cycle can mean dozens of waivers to request, follow up on, review, and submit. That's why lower-tier waiver collection is one of the most common bottlenecks in the payment process.
Managing Lien Waivers at Scale
Understanding the four waiver types is only the first step. As projects grow, the key is building a billing process that keeps pay applications, payments, and lien waivers connected, so the right documents go out at the right time, every time.
When everything lives in one system, it's easier to:
- Generate the correct waiver at the right point in the payment cycle.
- Track which waivers have been signed, submitted, or are still outstanding.
- Collect and organize lower-tier waivers alongside your own.
- Package complete payment applications that meet each GC's requirements.
- Reduce manual follow-up and avoid payment delays caused by missing paperwork.
That's why more commercial subcontractors are centralizing lien waiver management as part of their billing workflow instead of juggling spreadsheets, email threads, and disconnected files.
If you're ready to simplify lien waiver management, book a demo of Siteline to see how you can create, collect, track, and submit lien waivers alongside every pay application—all from one place.
Frequently Asked Questions About Lien Waivers
What is a lien waiver?
A lien waiver is a signed document in which a subcontractor, supplier, or other party gives up its right to file a mechanic's lien against a project in exchange for payment. Many GCs require them with each pay application to confirm the parties they're paying won't later lien the property for the same money.
For a more comprehensive overview of lien waivers, check out this guide.
What's the difference between a conditional and unconditional lien waiver?
A conditional lien waiver only becomes effective once payment is actually made. An unconditional lien waiver takes effect immediately because it confirms payment has already been received.
When should I sign an unconditional lien waiver?
Only after the payment has actually been received and the funds have cleared. Signing an unconditional waiver too early could mean giving up lien rights before you've been paid.
Do I need to collect lower-tier lien waivers?
It depends on the project and your contract. Many GCs require subcontractors to collect lien waivers from their suppliers, vendors, and lower-tier subcontractors before processing payment. Even when they're not required, collecting them consistently can help prevent delays later in the project.
Do all states use the same lien waiver forms?
No. Some states require statutory lien waiver forms, while others allow parties to use their own templates. Certain states also have specific notarization or formatting requirements, so always check the lien waiver laws in the state where your project is located. A good place to start is with our state-specific lien waiver guides.
Can a GC reject my pay app because of a lien waiver?
Yes. Many GCs review lien waivers as part of the payment application package. Using the wrong waiver, submitting an incomplete form, or failing to include required lower-tier waivers can delay payment until the issue is resolved.
